East End Booster Pump Station

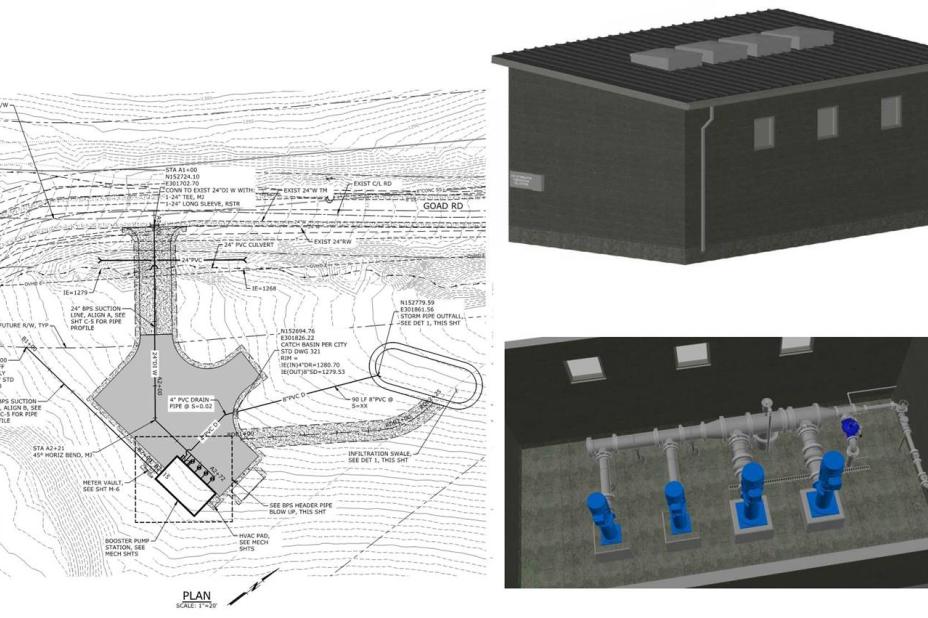

booster pump station contains multiple pumps and all the equipment necessary to control those pumps to maintain water pressure in an area. The East End Booster Pump Station includes provisions to serve the Hwy 11/30 Connector Road area with about 270 developable acres.

Depending on property acquisition and Business Oregon Infrastructure Finance Authority Board approval April 7, 2023, project expected to be advertised in April/May 2023.  Construction intended for spring/summer/fall 2023.

Funding

This project will be funded from the Business Oregon Special Public Works Fund.  There is about $10.8 million approved for loan drawdown, and water system rates will cover the debt service associated with this project.

  • 30% of this project will be reimbursed by new development through a reimbursement fee
  • 70% of this project will serve existing customers with future replacement of SE 7th Booster Pump Station
Project Title:East End Booster Pump Station Project
Estimated Construction Cost:$1,196,169
Actual Construction Cost:TBD
Project Type:Water
Final Project Cost (Construction + Engineering):TBD
Year Completed:2025

Why It's Needed
Booster Pump Stations help maintain water pressure at the City of Pendleton's different elevations.

Address
1001 Goad Rd, Pendleton, OR 97801, USA

Project Status

Completed

Project Milestones

November 2022

95% design review by murraysmith

February 2023

Final plan adjustments and plans submitted to Oregon Health Authority for review in March 2023.

July 2023

Funding approved and expected to bid in August 2023.

October 2023

Pendleton City Council awarded a contract to Mike Becker General Contractor in the amount of $2,477,701 for work related to the East End Booster Pump Station Project.

January 2025

East end Booster stem wall and generator pad poured

May 2025

East End Booster pumps were delivered on May 15th

July 2025

Paving completed, once electrical work is complete, startup could begin later this month.

October 2025

New system drives arrived and installed. Testing begins.
